Prepare effectively for your PMI PMI-SP PMI Scheduling Professional certification with our extensive collection of free, high-quality practice questions. Each question is designed to mirror the actual exam format and objectives, complete with comprehensive answers and detailed explanations. Our materials are regularly updated for 2025, ensuring you have the most current resources to build confidence and succeed on your first attempt.

Page: 5 / 5
Total 323 questions

Gary is the project manager of the NHF project, which is a part of a program in his organization. According to the PMBOK, how will Gary provide feedback to programs and portfolios?

A.

Status meetings

B.

Push communications

C.

Regular communications

D.

Status reports and change requests

Marty is the project manager of the recently completed NHK Project. The project was deemed successful by the project customer and they have signed the formal acceptance documentation. Marty has written the final project report, released the project team, and completed the lessons learned documentation. What else should Marty do in the closure of the NHK Project?

A.

Archive the project records.

B.

Summarize the project risks costs.

C.

Summarize the project variance.

D.

Close the project office.

Fill in the blank with an appropriate phrase.

The __________ includes a description of any collateral services required, such as performance reporting or post-project operational support for the procured item.

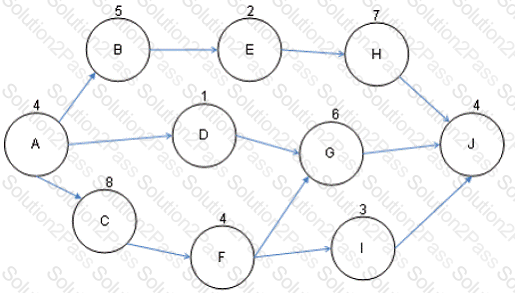

You are the project manager of the BHG Project. You are creating a network diagram as shown in the figure:

Mary, a project team member, reports that an identified risk is likely to happen in the project that will affect the completion date of Activity D . She reports that the risk event will likely cause the duration of the activity to increase by six days. If this happens what is the earliest the project can complete?

A.

32 days

B.

29 days

C.

27 days

D.

26 days

Fill in the blank with the appropriate word. ____ management sets the boundaries for the project and is the foundation on which the other project elements are built.

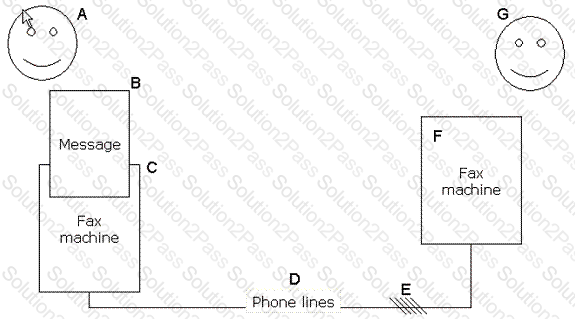

The figure given below demonstrates the communication model for a project. What role does the component E play in the communications model?

A.

Static

B.

Deterrent

C.

Noise

D.

Barrier

Nancy is the project manager of the JJJ Project. This project has recently been approved by the project customer as complete so Nancy must now finalize the administrative closure. Nancy needs to create the final project report to report the successes and failures in the project. Who should Nancy deliver this final project report to if she is participating in a projectized structure?

A.

Functional Management

B.

Project sponsor

C.

Whomever the communications management plan directs her to

D.

Project customer

Jack works as a project manager for the NHQ project. His project has a budget of $2,208,456 and is scheduled to last for three years. His project is currently forty percent complete though it should be forty-five percent complete. In order to reach this point of the project, he has spent $725,000. Management needs a performance report regarding the NHQ project. Management is concerned that this project will be over budget upon completion. Management would like to create a report telling them how much more the project will need to complete. What value should Jack tell the management?

A.

$1,087,497.74

B.

$755,000.56

C.

$1,112,978.45

D.

$790,988.76

Your project is forty percent complete though it was scheduled to be fifty percent complete as of today. Management has asked that you report on the schedule variance for your project. If your project has a BAC of $650,000 and you've spent $385,000 to date, what is the schedule variance value?

A.

-$75,500

B.

-$390,000

C.

-$487,500

D.

-$65,000

Fill in the blank with an appropriate phrase. The_____ allows the project team to look at the performance of the project to date, and use that data to make more accurate projections about the future.

You are the project manager of the NHA Project. This project is expected to last one year with quarterly milestones throughout the year. Your project is supposed to be at the third milestone today but you're likely only 60 percent complete. Your project has a BAC of $745,000 and you've spent $440,000 of the budget-to-date. What is your schedule performance index for this project?

A.

80

B.

1.02

C.

102

D.

0.80

You are the project manager of the GHY Project. This project is scheduled to last for one year and has a BAC of $4,500,000. You are currently 45 percent complete with this project, though you are supposed to be at your second milestone which accounts for half of the project completion. There have been some errors in the project, which has caused you to spend $2,073,654. What is this project's schedule variance?

A.

-$48,654

B.

13 percent

C.

-$225,000

D.

0.98

You have been hired as a project manager for Tech Perfect Inc. You are studying the documentation of planning of a project. The documentation states that there are twenty-five stakeholders with the project. What will be the number of communication channels for the project?

A.

300

B.

50

C.

600

D.

25

Fill in the blank with the appropriate word. When activities are logically linked, they become the . __________

You are a project manager in a matrix environment and management is concerned about the utilization of the resources on your project team and when you'll release them. What project management plan will guide how and when project resources will be released from the project team?

A.

Project Human Resources Management Plan

B.

Project Staffing Management Plan

C.

Project Communications Management Plan

D.

Project Schedule Management Plan

A construction company is about to start a new project. It requires hiring a project manager for this project. Which of the following are the most important skills that a person must have to be selected as a project manager?

A.

Problem solving

B.

Team building and human resources

C.

Leading

D.

Communication

E.

Negotiation and influential
